Wind turbine transportation underway: Port of Ngqura to Eastern and Northern Cape border

The transportation of wind turbine components from the Port of Ngqura to the Umsobomvu Wind Farm, located on the border of the Eastern Cape and Northern Cape provinces, is currently in progress. This significant logistical operation involves moving 81-metre-long turbine blades, tower sections, nacelles, hubs and other components over a distance of 550 kilometres via the regional highways.

Communities and regular commuters along these routes have become familiar with the impressive sight of these abnormal loads, reminiscent of similar projects in the region over the past decade.

“Transportation of key components, such as nacelles, drive trains, and hubs, began in mid-September, ahead of schedule to avoid potential logistical challenges, including transportation embargoes during the busy December-January holiday period,” said David Moncasi Hortet, Head of Sales for Africa at Nordex Energy South Africa.

Route selection is based on load dimensions, including height, weight, and length, directing components either along the N9 via Cradock to Middelburg or the N10 through Graaff-Reinet.

Specialist logistics and transportation teams, which will grow to over 60 members at the peak of the operation, manage the transport. However, challenges remain, such as the shortage of police resources to escort the heavy loads and strict Department of Transportation requirements, including deliveries being limited to weekdays.

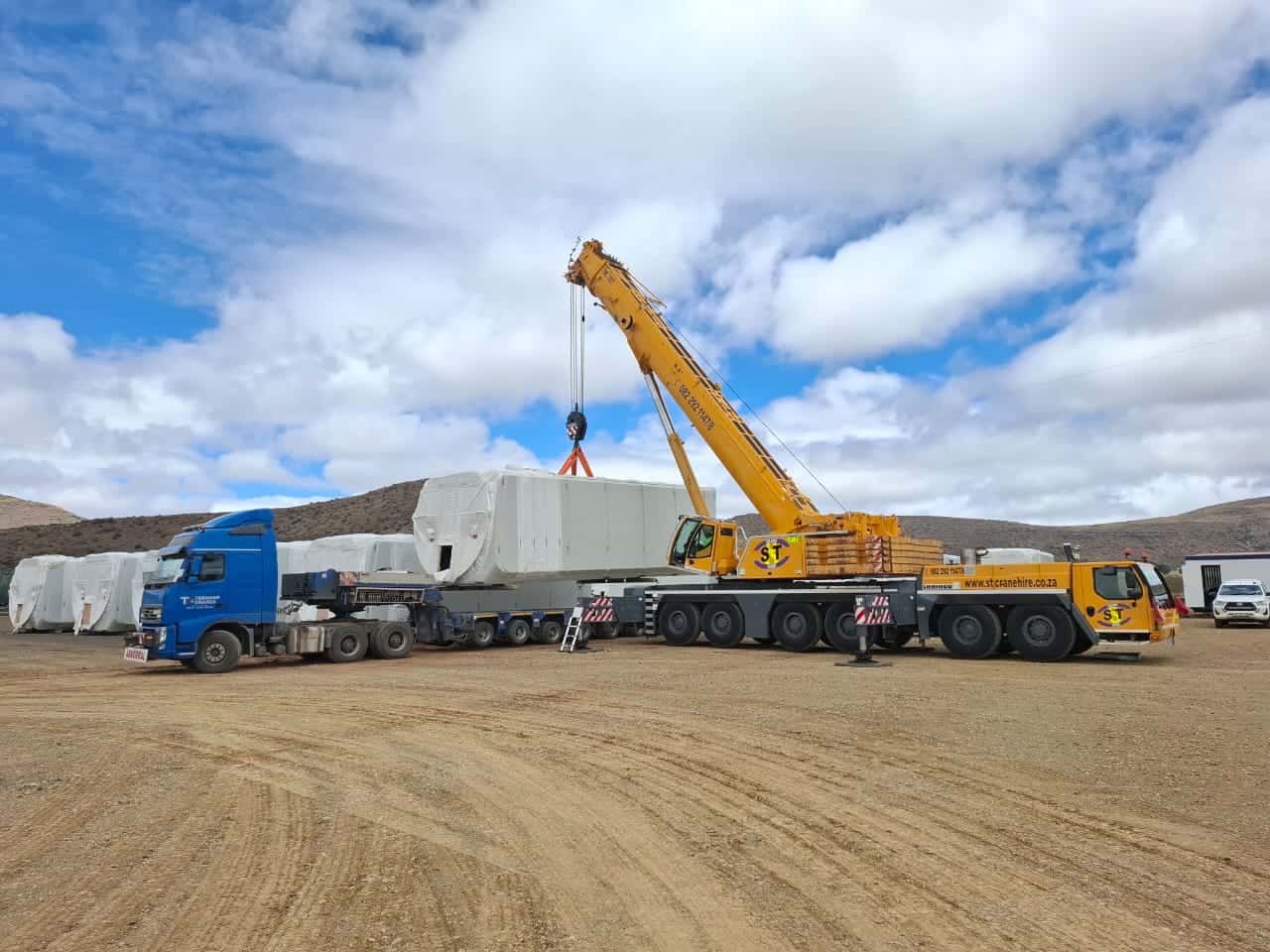

Components are delivered by sea on vessels from across the globe to the Eastern Cape port, where they are offloaded and stored before being transported to the wind farm sites.

Construction on the wind farms began earlier this year, with commissioning expected in Q1 2026. The Umsobomvu and Hartebeesthoek wind farms are part of the Koruson 2 cluster, owned by Envusa Energy, the joint venture partnership between EDF Renewables and Anglo American.

The wind farms will feature 50 Nordex N163/5.X turbines, with each farm generating 147.5 MW for a total capacity of 295 MW. Nordex will also provide maintenance for the turbines over the next 20 years.

Key Facts:

  • Total abnormal loads: 550
  • Loads delivered to date: 17
  • Transportation start date: Mid-September 2024
  • Expected completion: 2025
  • Heaviest component: Nacelle, 73 tonnes
  • Blade length: 81.5 metres
  • Turbine height: 118 metres
  • Embargo periods: No abnormal load transport on public holidays or during school holidays, unless special permission is granted.
  • Night-time transportation: Not permitted.
To enquire about Cape Business News' digital marketing options please contact sales@cbn.co.za

Related articles

MUST READ

City delivering real change

Behind every budget line, every policy, and every project there are real people, real challenges, and a shared future we are shaping. In a...

RECOMMENDED

Privacy Overview

This website uses cookies so that we can provide you with the best user experience possible. Cookie information is stored in your browser and performs functions such as recognising you when you return to our website and helping our team to understand which sections of the website you find most interesting and useful.

Strictly Necessary Cookies

Strictly Necessary Cookie should be enabled at all times so that we can save your preferences for cookie settings.

If you disable this cookie, we will not be able to save your preferences. This means that every time you visit this website you will need to enable or disable cookies again.
